Venture Global

Plaquemines LNG Fabrication Assembly & Site Installation

Project Highlights

Scroll for more

Related Projects

Motiva – H-Block Mechanical Project
Oil, Gas & Chemical
Refining
Combined Cycle

Motiva

arrow_outward
H-Block Mechanical Project
MHI/Exxon – North American Growth (NAG) Project
Oil, Gas & Chemical
Petrochemical

MHI/Exxon

arrow_outward
North American Growth (NAG) Project
Dow - Eagleray Equipment & Structure Foundations Project
Oil, Gas & Chemical
Chemical

Dow

arrow_outward
Eagleray Equipment & Structure Foundations Project

When it matters most, we’re ready.

info@performance-contractors.com
(225) 751-4156

Venture Global - Plaquemines LNG Fabrication Assembly & Site Installation

Performance Contractors was selected as a module fabrication and site assembly contractor by Venture Global for their Plaquemines LNG facility.

Scope/Services

Civil

Electrical & Instrumentation

Equipment Assembly & Erection

High Alloy Welding

Hydrotesting

Millwright Alignment Work

Module Assembly

Module Installation

Pipe Detailing

Pipe Fabrication

Pipe Installation

Rigging & Heavy Lifts

Soft Crafts

Structural Steel Erection

Industry

Oil, Gas & Chemical

Liquified Natural Gas (LNG)

Capability

Capital Construction

Module Assembly & Installation

Pipe & Steel Fabrication

Location

Plaquemine, Louisiana

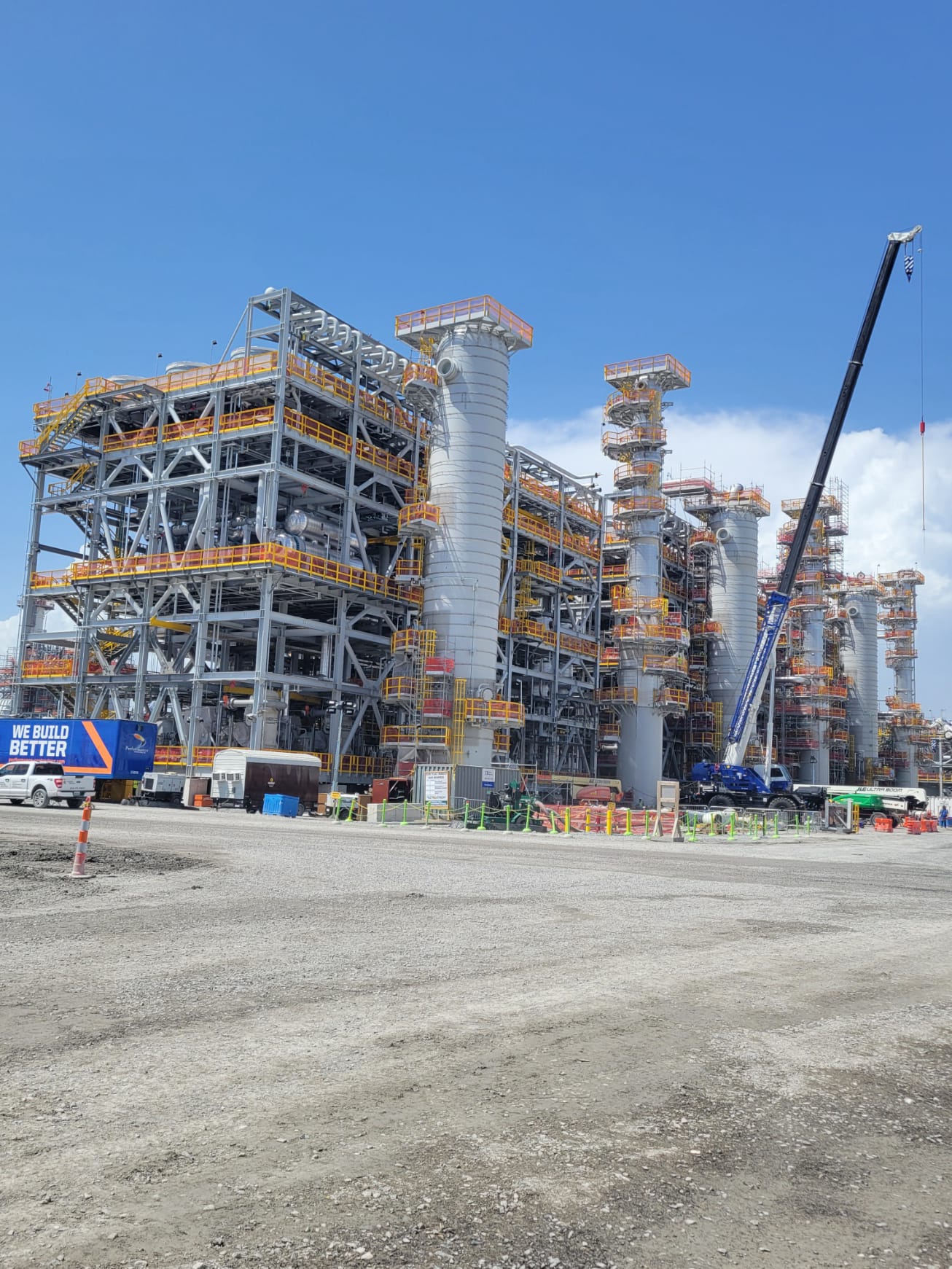

The Challenge

The scope of work included onsite fabrication of 14 process modules weighing up to 3,500 tons and 52 pipe racks weighing up to 400 tons each. This scope included all aspects of construction including pipe fabrication, steel erection, equipment setting, paint, fireproofing, insulation, E&I, transportation, and module loadout to the final destination in Plaquemines.

What We Did Differently

To date, this is the largest project undertaken by Performance Contractors in our 45-year history. This revolutionary project spanned across 4 job sites, a 35 month duration with a coordinated company-wide effort where manpower reached 8,000 employees.
‍

Venture Global LNG strategically designed overall project schedule improvement by allowing a significant portion of the project to be modularized onsite. Performance worked closely with Venture Global to ensure timely delivery of all 66 modules to support the site's critical path schedule. Performance became a trusted lead contractor demonstrating collaboration, adaptability and partnership to meet dynamic project needs. The combination of modular construction, an aggressive delivery schedule, and close coordination with onsite system completions resulted in significant savings to the overall project duration.

Project Total Quantities

  • Concrete { 1,200 CY
  • Modules Fabricated { 66 EA
  • Modules Set { 175 EA
  • Largest Module Fabricated { 151’L x 76’W x 106’H
  • Steel Install { 23,893 Tons
  • Pipe Install { 546,985 LF
  • Spools Fabricated { 30,100
  • Equipment Set { 547 EA
  • Field Welds { 30,082
  • Cable Tray { 834,000 LF
  • Cable Installed { 9,515,000 LF
